Guide · Activity Explorer

Finding any activity in a P6 schedule: a practical guide to the Activity Explorer

Most questions about a schedule start with which: which activities are critical, which start in the next quarter, which are constrained, which lost float, which crews are on the work. The Activity Explorer is the page that answers them: one flat list of every activity, scoped by tiles and filters that stack, counted as you go, and taken away as a workbook or a list of IDs. This guide shows what it can do that a quick look does not reveal, with recipes and a worked example on a metro extension's August update.

Trestle Path Analytics Corp.Worked example: Vireo Line demonstration set10 min read

Sign in ↗Product tour →Pricing →

The short answer

The Activity Explorer is every activity in the schedule as one sortable list, with a row of tiles that count the critical, zero-float, near-critical, in-progress, constrained and milestone work and scope the list in one click. Every filter stacks: the tile, a search, a box under every column that takes expressions such as >30 or 30..90, a period window and an advanced filter, and the tiles recount as you narrow. The same list can be read on last month's update or the baseline, traced along any activity's driving chain, grouped with totals, or turned into the resource assignments behind it, by month. It reads the file in your browser and never writes back.

Every activity in one listTiles that recount as you narrowFilters that stackAssignments by month

The Explorer and the Schedule Reader

Both read the same activities. They answer different questions, and a set found on one can be sent to the other.

Schedule ReaderActivity Explorer
ShapeThe schedule in its WBS structure, with a Gantt chartA flat list, sorted however you like
Best atReading the plan, following logic on the chart, printing a sheet, raising review commentsCounting and finding: which activities, how many, and what they share
ScopeThe whole file, including retired WBS branchesThe live schedule the analysis pages read
Other filesThe baseline columns compare against the baseline or the prior updateThe whole page can be read on the current file, the prior update or the baseline
Unique to itBands with roll-ups, the chart, the A3 sheet and the web sheetThe tiles, number expressions in every column, group totals, the assignments views

Five ways to narrow the list, and they stack

  1. The tiles. All activities; under Criticality: Critical (the critical path, Float Path 1), Zero float, Negative float, Near-critical (more than zero and up to ten days) and Float path 2-3; under Progress: In progress, Not started, Complete; under Attributes: Constrained, Milestones, LOE / summary. One click scopes the list, a second click on the same tile clears it, and every tile's count is measured against whatever else is filtering, so the row of numbers describes the set you are looking at.
  2. The search box. It matches the ID, the name and the WBS path, and also every activity-code value, every user-defined field and the notebook text.
  3. A box under every column. Text boxes match "contains". Number boxes take expressions (below). Status, type, constraint, calendar, critical and every activity code offer a list of the values actually in the schedule.
  4. The period. Around data date, Next 30d, Next 90d, Last 90d or any window on the slider; anything whose work overlaps the window is listed, including work already under way.
  5. Advanced filter… Any column, with all or any, operators by field type, and a live count as the criteria are built.
Type in a number boxLists
>30more than 30
<-10less than −10, for example ten days late against the baseline
>=0zero or more
30..90between 30 and 90
=1exactly 1. Without an operator a number box matches as text, so 1 would also find 10 and 12

The line above the table says what is in force: the period, the tile ("Scope"), the advanced filter, a set sent from another page, and "Showing N of N matching". clear filters clears the boxes, the search, the tile and the criteria; clear period clears the window.

What most people never find

CapabilityWhere it isWhat it is for
Last month's list, and the baseline'sCurrent / Prior / BaselineThe whole page re-runs on the other file, with your tile, boxes, sort and period carried across: the same question asked of last month
The driving chain as a filterThe activity drawer: Filter the Explorer to this activity's driving chainLists what drives an activity and what it drives, in date order. Switch to Prior or Baseline and the chain is traced again on that file
Open ends by sortingThe Predecessors and Successors columnsThey sort by how many links an activity has, so ascending puts the open ends first
Groups with totalsGroupBy WBS, any activity code, calendar, status, float band, resource, type, constraint or month; each band totals the durations (Σ), weights the per cent complete and gives the lowest float
Who is on the workAssignments, then List or By monthOne row per resource assignment on the activities listed, with budgeted, actual, remaining and at completion; or units by month for each resource, totalled by type, never across types
Seven layoutsLayoutClassic, Progress / Update, Baseline / Variance, Critical / Float, Constraints, Logic / Open Ends, Durations
Review columnsColumns…Claim gap, Expected Finish, Calendar h/day mismatches, Secondary Constraint, Float Path, Longest Path, the Notebook, every activity code and user field
Every table in the drawer travelsThe activity drawerThe predecessor and successor tables carry their own Excel, CSV and Copy buttons, and say which link drives and by how much the others miss
The list, elsewhereSend toTo the Schedule Reader in its WBS structure, to the Linear Schedule, the first row to the Logic Tracer, the IDs one per line, or the table as tab-separated text for a spreadsheet
The same view next monthSave setup, Load setup, Reset viewColumns, boxes, tile, period, group and criteria in one file. A preset period is recalculated from the new file's data date, so "Next 90d" stays the next 90 days
The whole review, keptSave session, Load session (top bar)This page with every other page and the comment log in one file on your computer; load it onto the same schedules another day and the review is as you left it

Recipes

Each recipe is a question a reviewer asks of an update or a baseline; the checks follow AACE 53R-06 for updates and AACE 78R-13 for baselines. Counts on your screen come from your own file.

1. What critical and near-critical work starts in the next quarter?

  1. Press Next 90d in the Period row. The tiles recount to the window.
  2. Click Critical, or Near-critical; or type <=20 in the Total Float box for a band of your own.
  3. Set Group to Month it starts for a lookahead by month, then Export to Excel.

2. Which constraints are there, and are they doing anything?

  1. Click Constrained and choose the Constraints layout: type, date, float, start and finish side by side.
  2. The tile counts primary constraints. An activity can be held by a secondary constraint with the primary blank, so clear the tile and use Advanced filter…: Secondary Constraint is not empty.
  3. Compare each constraint date with the activity's dates. A constraint on critical work that is not holding a date today will hold one as soon as the work ahead of it recovers; each needs a reason in the narrative.

3. Where are the open ends?

  1. Choose the Logic / Open Ends layout.
  2. Click the Predecessors title, then Successors: they sort by how many links an activity has, fewest first. The project's own start and finish milestones are expected at the top; anything else is a question.

4. Long durations and high float

  1. Choose the Durations layout and type >44 in the Orig Dur box. Then choose Critical / Float and type >44 in the Total Float box.
  2. Forty-four working days is the common DCMA convention, not a rule. Long activities hide progress, and high float often means missing successors; read both against the project's own detail.

5. Progress claims worth a question

  1. Click In progress and choose the Progress / Update layout.
  2. Add Claim gap (physical per cent minus duration per cent; red beyond 15 points either way) and Expected Finish, which makes P6 back-calculate remaining duration.
  3. Type >15 in the Claim gap box: progress claimed well ahead of the time burnt.

6. What drives this milestone, and what drove it last month?

  1. Click the milestone's ID (or double-click its row) and press Filter the Explorer to this activity's driving chain. The list becomes the chain, in date order, under a "Driving chain of …" pill.
  2. Switch to Prior: the same chain on last month's file. Then Baseline. Activities that joined or left the chain are the story of the month.

7. Who is on the work, month by month?

  1. Set the period, for example Next 90d, and any tile or filter.
  2. Press Assignments, then By month: each resource's units for each month of the window, with Earlier and Later columns and a subtotal for each resource type.
  3. Narrow with Every resource type, Resource contains… or Activity contains…, then Export to Excel.

8. Did last month's numbers change?

  1. Press Assignments, then List, and type the activity in Activity contains….
  2. Read Actual, Remaining and At completion, then switch to Prior. Actual units should only grow; when they fall, previously reported progress was changed, and AACE 53R-06 asks for the reason in writing.

Worked example: a metro extension's August update

The Vireo Line Extension is a fictional twin-bore metro extension supplied with the product as a demonstration set; nothing in it is real. Its August 2026 update was read with July as the prior and the 2020 baseline.

The tiles

The live schedule has 210 activities (two more sit in a retired WBS, which the Schedule Reader shows and the Explorer leaves out). The tiles read 18 critical, 9 at zero float, none negative, 12 near-critical and 6 on float paths 2 and 3; 15 in progress, 63 not started and 132 complete; 5 constrained, 25 milestones and 3 level-of-effort. Pressing Next 90d recounts them to the 29 activities at work between 1 August and 30 October: 2 critical, 15 in progress, 14 not started. Typing <=20 in the Total Float box leaves six, the work most likely to decide the next quarter.

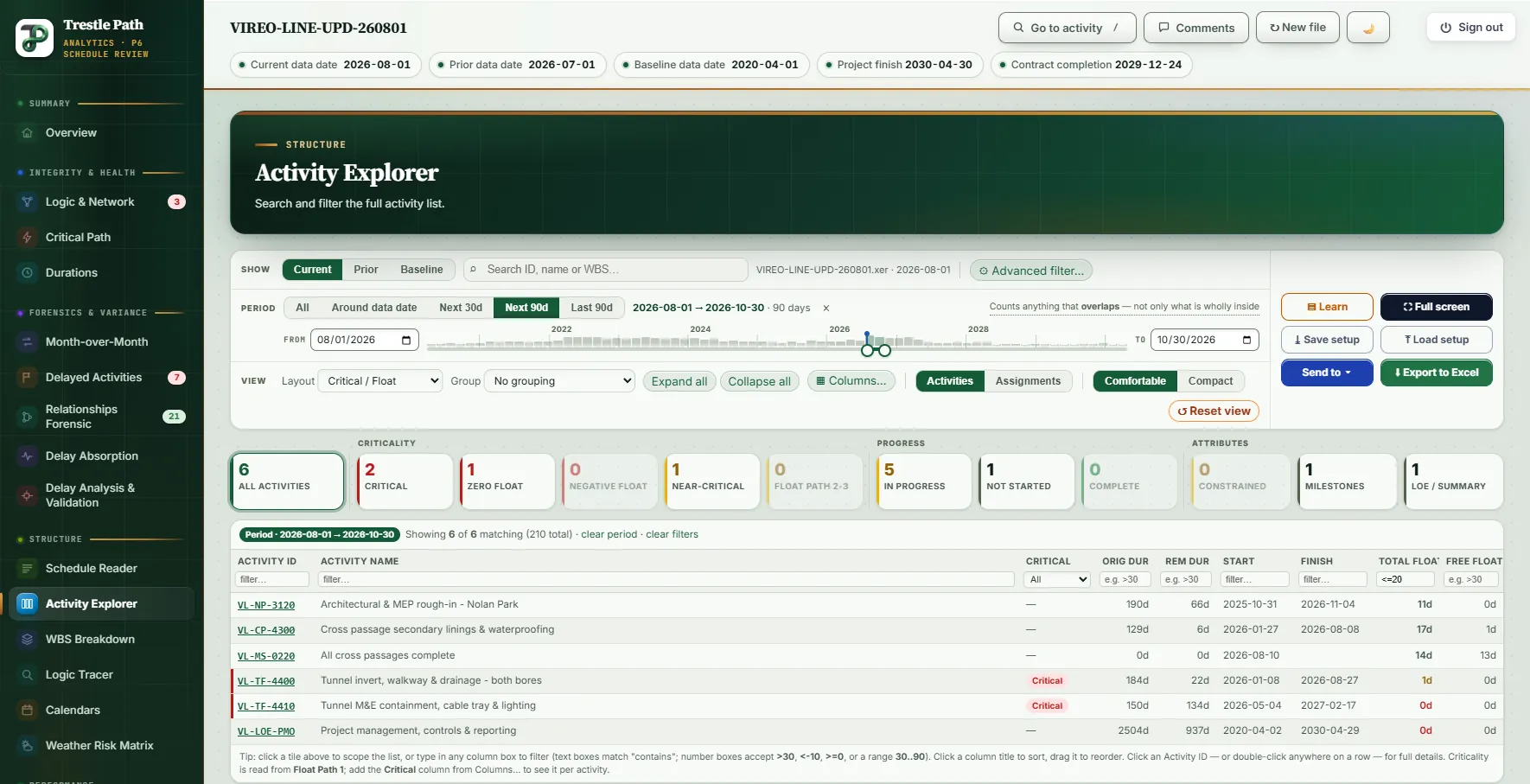

The Activity Explorer with the period set to the next 90 days, the Critical / Float layout and a total float filter of 20 days or less: six activities, with the tiles recounted to the set
The next 90 days, Critical / Float layout, total float of 20 days or less: six activities, and every tile recounted to them.

The chain into Revenue Service Date

Traced from the Revenue Service Date milestone, the driving chain holds 18 activities in August. On the July file it held 15; the three that joined are the activities of a new delay event, Impact 11. On the baseline it held 41, running back through design, the tunnel drives, trackwork and communications. The chain today runs through tunnel fit-out, signalling and the testing sequence instead. That one comparison, three clicks, is the summary of how the project's critical path has moved since it was planned.

Constraints on critical work

Five activities are constrained. Two of them, Operational readiness & staff training and Pre-revenue operations & trial running, are on the critical path with Start On or After constraints dated April and July 2029, while the work is forecast to start in September 2029 and January 2030. Neither constraint holds a date today; both would, if the testing sequence recovered time. That is a question for the narrative, not yet a finding.

Hours that went down

The assignments of the cross-passage linings (VL-CP-4300) tell a story the dates do not. In July the Tunnel Crew had booked 31,200 hours, its whole budget, with 1,680 to go: 32,880 at completion. In August the actual reads 26,304 hours and the remaining 4,896, so at completion is back on the budget exactly. Previously reported hours were reduced, and the question to ask is why.

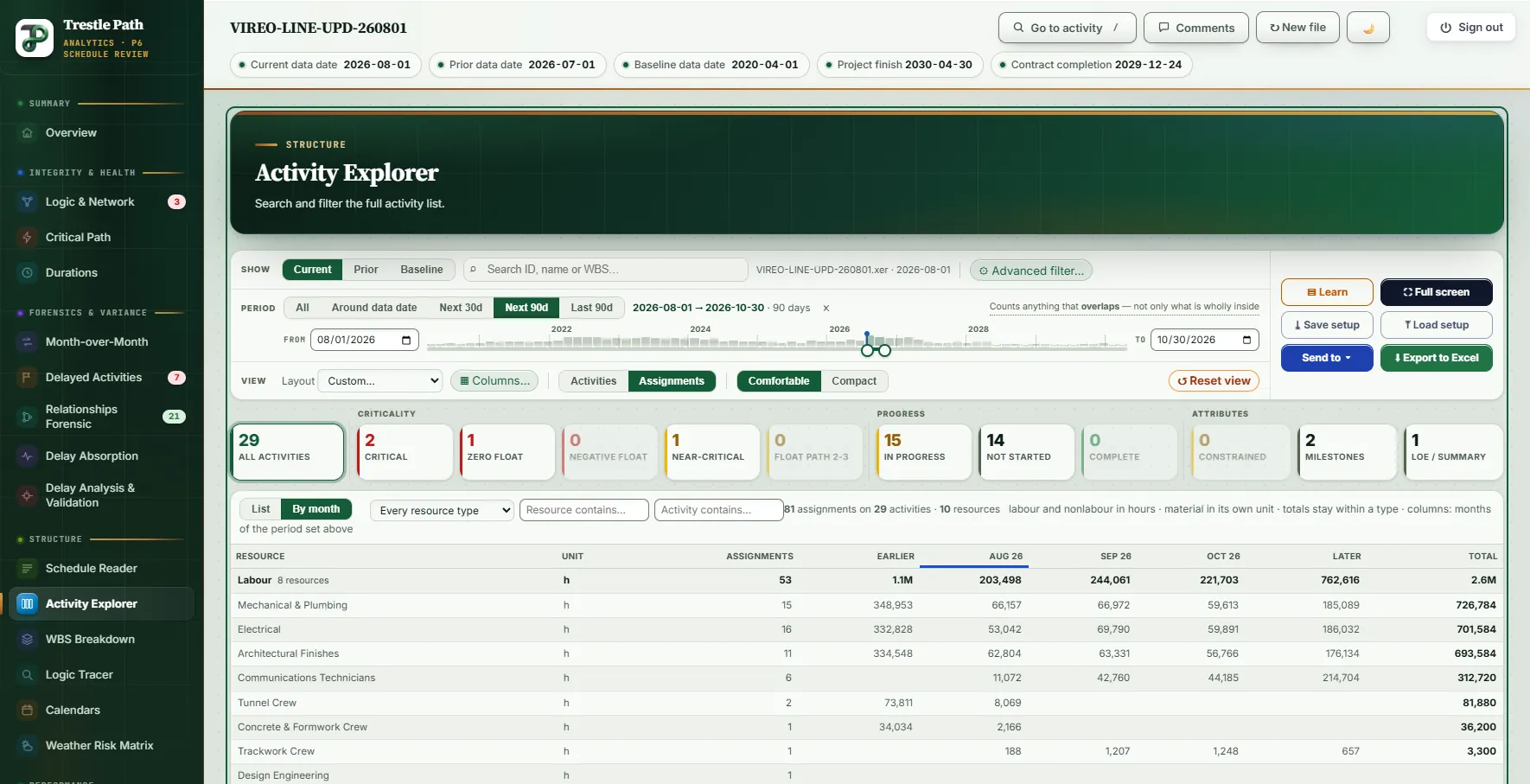

The Activity Explorer's assignments view by month for the next 90 days: labour, nonlabour and material resources with units for each month and subtotals by type
Assignments by month for the next 90 days: 81 assignments on 29 activities, labour in hours, the value resource and concrete in their own units.

For the next 90 days the same activities carry 81 assignments across ten resources. The eight labour resources hold about 203,000 hours in August, 244,000 in September and 222,000 in October, spread evenly over each assignment's dates.

Keyboard

KeyWhat it does
Ctrl+K or /Go to any activity by ID or part of its name
EscClear the search box, close the drawer, then leave full screen
Arrows, Shift, Home, EndMove a period handle a day, 30 days, or to either end

Click a column title to sort (numbers and dates start with the largest), drag it to move the column, drag its edge to resize it. Click an Activity ID, or double-click anywhere on a row, for the drawer.

Limits

  • It reads, it never edits. Findings raised from the drawer go to the comment log, which lives with the Schedule Reader.
  • The baseline columns follow the Schedule Reader. BL Start, BL Finish and both variances compare against whatever the Reader's BL from is set to; they are hidden while the page reads the prior or the baseline itself.
  • By month is an even spread of each assignment over its dates, for a quick view of who is on the work. The curve P6 itself draws, by period, is Resource Performance's job.
  • Near-critical is ten days and the long and high-float thresholds are 44 days: conventions, not standards.
  • Copy the table takes up to 5,000 activities; the Excel export has no limit.
  • Microsoft Project XML carries no resource assignments, activity codes or notebook; the Unique ID is the key, with Project's row number beside it, and search finds either.

Where to find it

The Activity Explorer is included in every plan, from Reader up, and in the fourteen-day trial. Current prices are on the pricing page. For the same activities in their WBS structure with a Gantt chart, see the Schedule Reader; for everything that changed between two updates, see how to compare two P6 updates. The section's own guide, under Learn in the product, covers every control.
